Update - August 8, 2022

The 20 inch diameter well casing is onsite, however, the installation has been delayed while the contractor secures a high quality gravel pack which is a critical component of the well. The shipment of gravel that was delivered failed to meet the required specifications and was rejected.



It is believed that an acceptable gravel pack will be delivered in approximately seven to ten days, at which time the contractor will resume reaming the hole.

Update - July 27, 2022





The drilling crew is back and will begin reaming the hole later this week to a diameter of 28 inches.

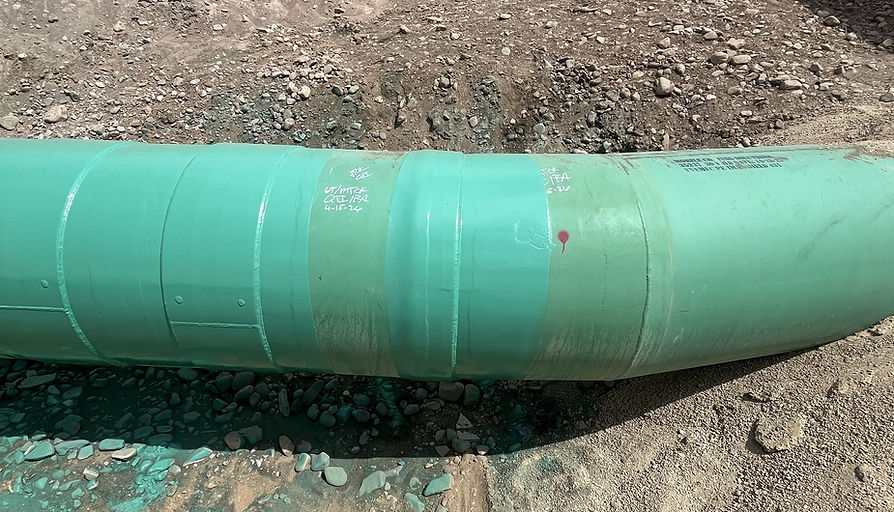

This will be followed with the installation of the 20 inch diameter well casing with its screens to a depth of approximately 950 feet.

Update - July 13, 2022





The drillers are headed home, but they will be back!

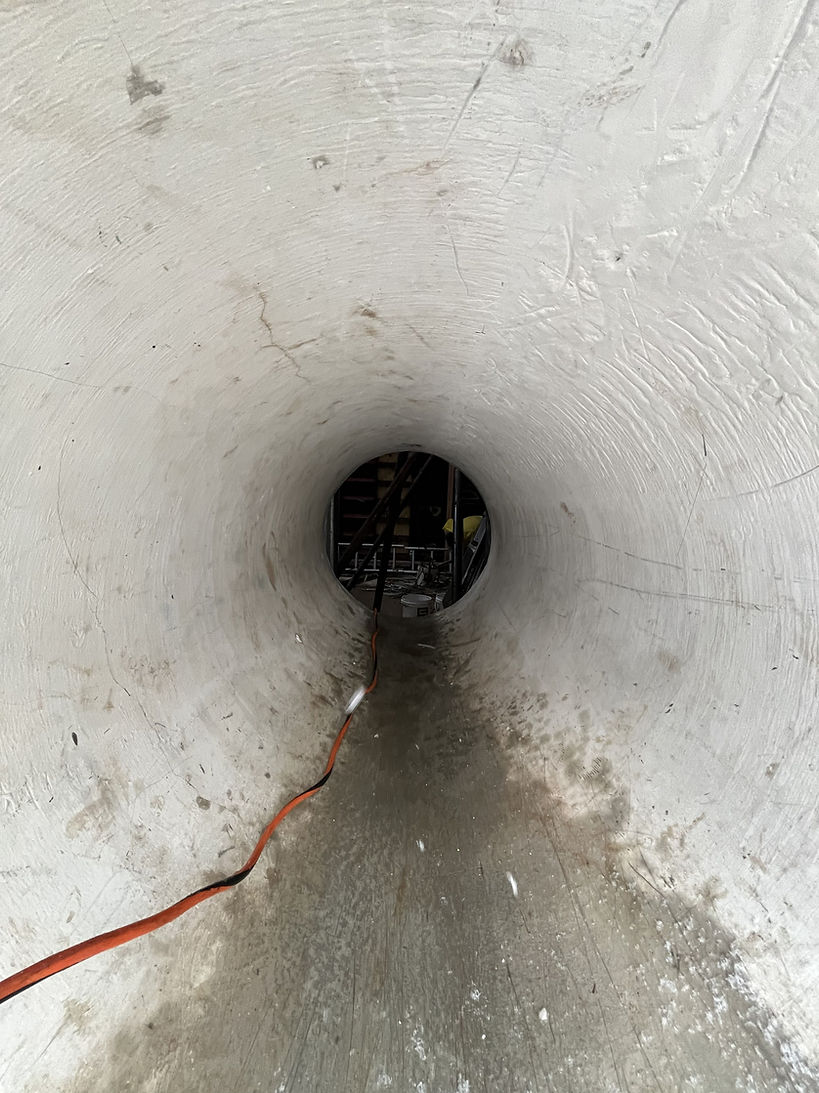

Last night the drillers finished water quality sampling. Currently they are filling the 17-1/2 inch pilot hole with pea gravel from a depth of 950 feet to 250 feet below grade.  Once complete, they are heading home for much needed time off.

The well site will be quiet for approximately two weeks and then, the drilling crew will be back to begin reaming the hole to a diameter of 28 inches.

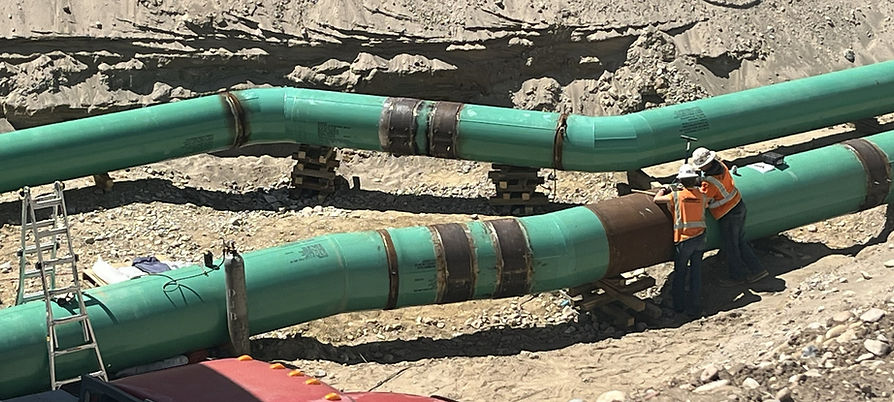

This work will include the installation of the 24 inch diameter well casing with its screens to a depth of approximately 950 feet.

Update - July 6, 2022









Well drilling began June 17, 2022. Currently the smaller 17.5 inch diameter pilot hole is at close to 850-foot depth.



Once the target depth of 900-feet is reached, operations will switch to water quality sampling which will take place at various depths. This process is critical to identify the best quality water in each aquifer.



At the completion of the testing period there will likely be a period of up to two weeks without the drill rig in operation. Thereafter, the drilling with the 28-inch reamer will commence and the operation will run 24/7 until final depth is reached.

After the drilling process is complete, well development will begin. This process is very important to produce a productive and efficient well. Well development is completed by test pumping the well for a period of up to 400 hours. Fortunately, this process can be completed during normal working hours.  However, the last 24 hours of pumping will be continuous.

From start to finish the total process to drill and develop the well is expected to take two to three months.

Update - June 25, 2022

Well drilling has begun at the northeast section of the Heritage Park site. There is equipment and a tower in that area. The contractor has erected sound walls on the north, east and south sides of the drill site. The drilling for this well will take approximately two to three months and will run continuously, twenty-four hours a day - seven days a week until the work is completed. This well will potentially reach a depth of up to 900 feet.

After the drilling process is complete, well development will begin. This process is very important to produce a productive and efficient well. Well development is completed by test pumping the well for a period of 400 hours. Fortunately, this process can be completed during normal working hours.  However, the last 24 hours of pumping will be continuous.

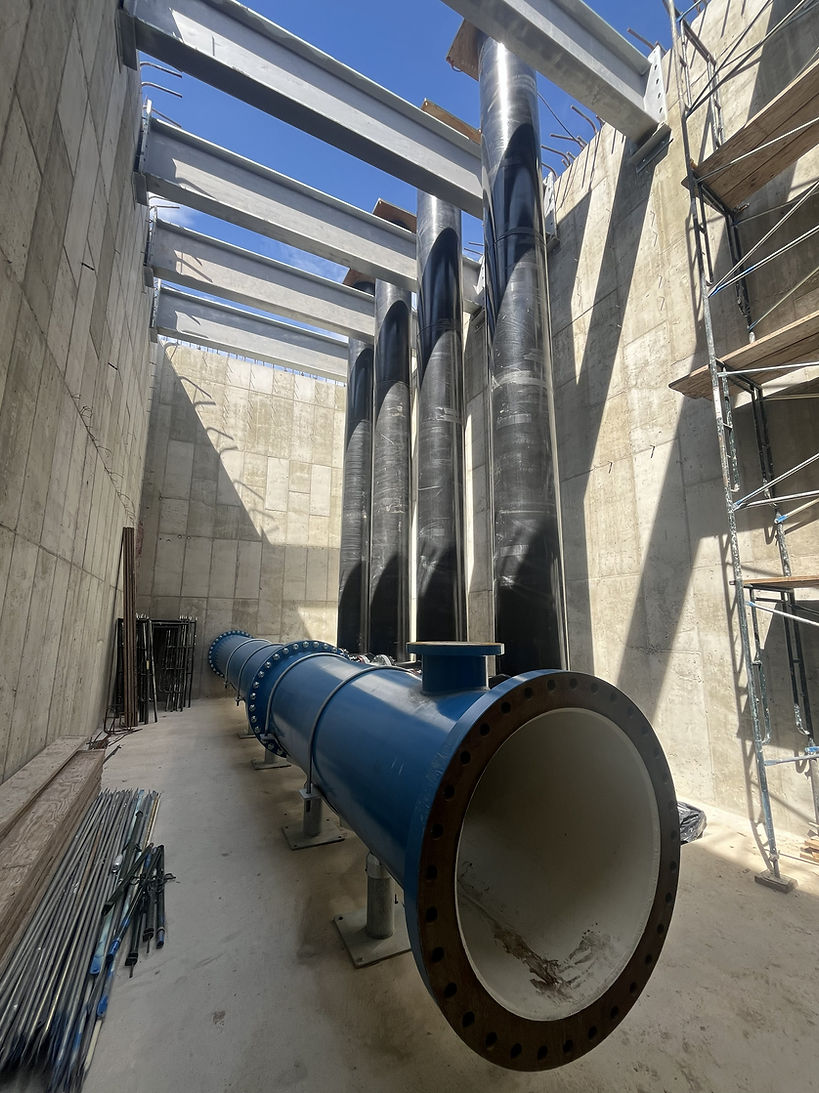

Upon completion this well will assist the water supply for the 10 million gallon buried tank on this site.


Drilling for the 900 foot depth well has commenced as of June 23rd and will run non-stop (24/7) for the next 2-3 months.

Initial Start Up

From June 21st to June 23rd the well driller installed a 40 foot casing at the surface of the drill site.

Update - June 23, 2022
